Project 01 / Riyadh 2026Weekly reports R5, R10

Parking 12

From execution
to handover

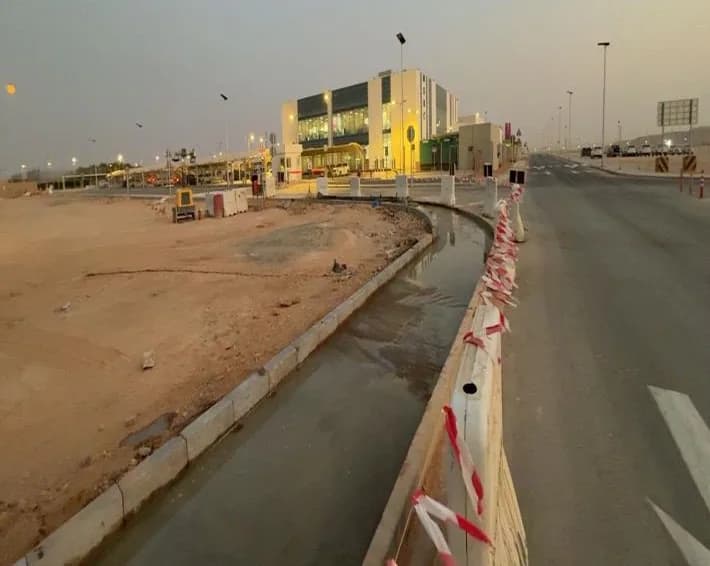

Asphalt road with chevron markings and zebra crossing beside a barricaded kerb median under works, red-white tape, light tower, distant workers and vehicles, glass building behind
Site record / 27 Aug

Finishing works, signage and pre-handover quality on a parking package, ending with coordination of a small field crew and its equipment.

  • Finishing / handover
  • COOP trainee
Illustrative render

Numbers

6

Workers coordinated

Source: Training summary

2

Shifts in one day

Source: Weekly report 5, 23 July
Figure notes
  • 6 Workers coordinated

    Final finishing crew before handover, with one Bobcat and one JCB.

    Source: Training summary
  • 2 Shifts in one day

    Worked 00:00 to 05:00 and 15:00 to 00:00 on 23 July to support CLSM and interlock preparation on a tight schedule.

    Source: Weekly report 5, 23 July

Role

  • Supervised: 3
  • Coordinated: 1
  • Monitored: 2
  • SupervisedShuttering, CLSM pour and white-sand beddingSource: Weekly report 5, 23 July

    Supervised shuttering, the CLSM pour and white-sand bedding ahead of interlock installation across two shifts during a schedule-critical period, checking that surveyors set level stakes before the pour.

  • SupervisedSign positioning against the updated drawingsSource: Weekly report 5, 23 July

    Participated with the engineering team in implementing a revised execution plan that added traffic and directional signs, supervising sign positioning against the updated drawings and circulation plan.

  • SupervisedWalkway concrete placement, levelling and finishingSource: Weekly report 10, 27 August

    Prepared and levelled the pedestrian walkway area in front of the parking, installed the polyethylene membrane and supervised concrete placement, levelling and finishing.

  • CoordinatedFinishing crew: 6 workers, 1 Bobcat, 1 JCBSource: Training summary

    Coordinated a field crew and equipment (6 workers, 1 Bobcat, 1 JCB) during final finishing activities before handover.

  • MonitoredBus lane kerb edge needing a tapered transitionSource: Weekly report 10, 27 August

    Followed the bus lane alignment in front of the parking and identified a kerb edge that needed a tapered transition for bus turning; measurements were taken for the modification.

  • MonitoredInterlock, foundations and pre-handover inspectionSource: Training summary

    Followed interlock compaction and the sweeping of dry sand into the joints, foundation preparation, formwork, reinforcement and concrete casting, and the pre-handover inspection of alignment and finish quality.

Project context

Parking 12 is one of the parking packages inside the Qiddiya Speed Park construction environment. During the training period the package moved from interlock and foundation execution through landscaping, signage and markings toward pre-handover finishing.

Works in front of the package in late August included a pedestrian walkway pour and preparation of the adjacent bus lane.

COOP trainee supporting the site team: following crews, checking executed work against the drawings and reporting observations.

Near handover, assigned responsibility for the final finishing works and coordinated a field crew of six workers with one Bobcat and one JCB. This was crew-level coordination within the site team's plan, not management of the package.

Sequence

  1. No site record
    01

    Foundations for site elements

    • Foundation preparation, excavation, formwork, reinforcement and concrete casting for site elements including canopies.

      Source: Training summary

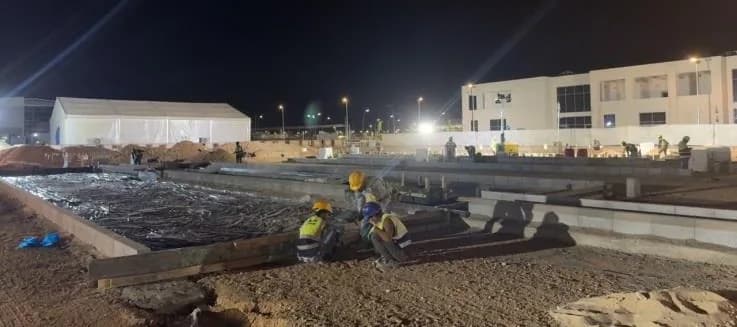

  2. Night pour: concrete pump boom over freshly placed CLSM in a kerbed bay, crew of about six in hi-vis at mid distance
    02

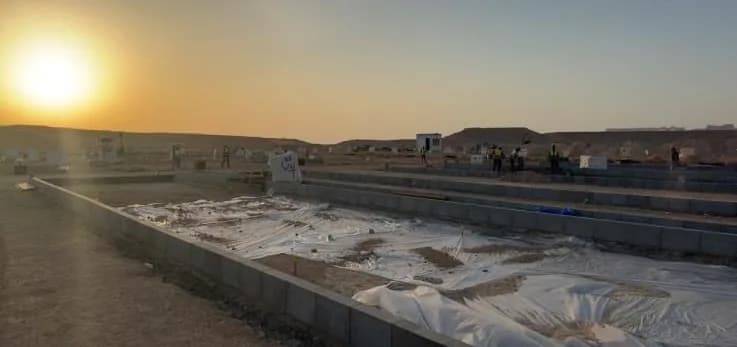

    Prepared layer

    • Shuttering installed around the designated sections, then CLSM poured to the surveyed level stakes.

      Source: Weekly report 5, 23 July
  3. No site record
    03

    Interlock

    • White sand bedding placed on the CLSM, then interlock paving laid.

      Source: Weekly report 5, 23 July
    • Interlock compacted and dry sand swept into the joints.

      Source: Training summary
  4. No site record
    04

    Landscaping

    • Landscaping works in the parking area.

      Source: Training summary

  5. Newly installed give-way, no-right-turn and keep-left signs at a parking exit onto a road at night, truck parked in distance
    05

    Signs, markings, walkway

    • Revised layout implemented: additional traffic and directional signs positioned to the updated drawings.

      Source: Weekly report 5, 23 July
    • Pedestrian walkway in front of the parking levelled, membrane installed, concrete placed and finished.

      Source: Weekly report 10, 27 August
    • Exposure to road markings, parking signs and canopy works.

      Source: Training summary
  6. Night view of a finished asphalt road with lane markings, interlock walkway in foreground, lit canopy parking with accessible bays at right, three workers on the road and one under the canopy, lit buildings behind
    06

    Pre-handover

    • Final finishing activities coordinated with a crew of six workers, one Bobcat and one JCB; alignment and finish quality inspected before handover.

      Source: Training summary

Ground to built

Illustrative render: the same pad built, with paving, canopies, lighting and treesIllustrative render: the graded pad, set out with survey pegs and linework
Illustrative render

Site records

10 photos / 23 Jul to 27 Aug

Takeaways

  1. Coordinating a small crew and its equipment.

  2. Reading revised drawings, translating changes to the crew.

  3. Handover is a quality process.

Full record

Observations from site

  • The finished interlock level is set before the CLSM pour: surveyors install level stakes so the CLSM reaches the elevations on the approved drawings.

    Source: Weekly report 5, 23 July
  • Sign positions were checked against the revised traffic circulation plan, not only against the original layout.

    Source: Weekly report 5, 23 July
  • A polyethylene membrane was installed under the walkway slab before the pour.

    Source: Weekly report 10, 27 August
  • Bus turning movements exposed a kerb edge that needed a tapered transition; the fix was measured on site before any modification.

    Source: Weekly report 10, 27 August

What I learned

  1. 01

    Coordinating a small crew and its equipment during final finishing works.

  2. 02

    Reading revised drawings quickly and translating the change to the crew on site.

  3. 03

    Handover is a quality process: alignment and finish quality are inspected before the package is handed over.
